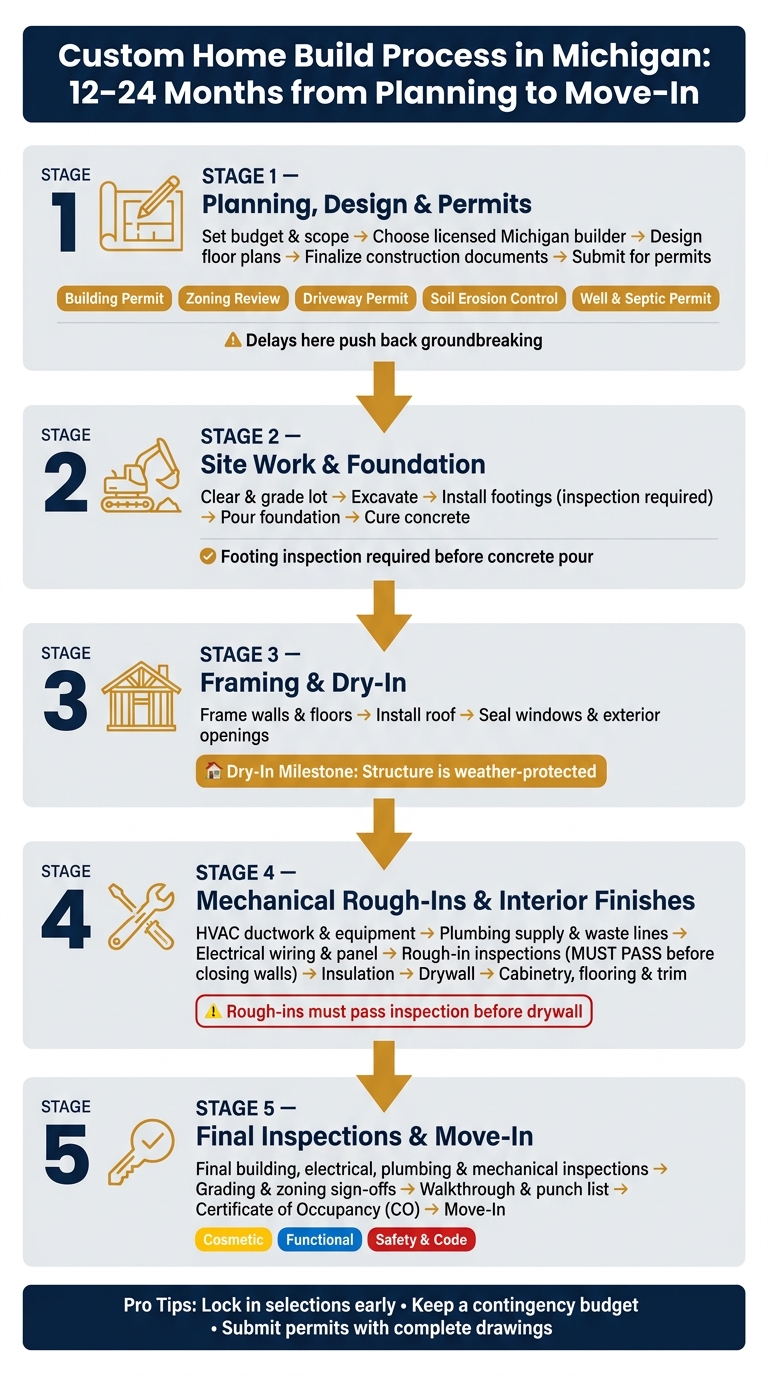

What Actually Happens During a Custom Home Build
If I build a custom home in Michigan, I should expect a process that often takes 12 to 24 months from early planning to final walkthrough. Most of that time goes into four parts: planning and permits, site work and foundation, framing and rough-ins, and final inspections before move-in.
Here’s the short version:
- Before building starts, I set the budget, choose the builder, finish the plans, line up financing, and get permits.
- Then the lot gets prepared, including clearing, grading, excavation, footings, and foundation work.
- Next comes the shell, with framing, roofing, windows, and exterior sealing so crews can work inside.
- After that, plumbing, electrical, and HVAC go in before insulation, drywall, cabinets, flooring, and trim.
- At the end, the home needs final inspections, a punch list, and a Certificate of Occupancy before move-in.
A few facts stand out. Permit delays, site issues, and weather can shift the schedule. Rough-in work must pass inspection before walls are closed. And even small late changes can add time and cost fast.
If I want fewer surprises, the main things to focus on are clear plans, early selections, and a backup budget for changes or site problems.
That’s the custom home build process in plain terms: plan first, build in stages, inspect along the way, and close out the last details before move-in.
Custom Home Build Process: From Planning to Move-In
Planning, Design, Budget, and Michigan Permits
Setting the Budget, Scope, and Build Team
Before anyone sketches a floor plan, lock in the big decisions: your budget, target square footage, foundation type, exterior look, and any special-use spaces. The more specific you are at the start, the less likely the design process is to wander.
After you define the scope, choose a builder with an active Michigan Residential Builder Company license before you sign anything. That builder helps coordinate the moving parts between you, the designer, and local permit offices.
It also helps to set aside a contingency fund before construction begins. Unexpected site conditions and change requests during the job can add cost fast. If the full plan goes past what you can spend right now, phase the build and push lower-priority items to later.
Those early choices guide the first floor plan ideas.
From Floor Plans to Permit-Ready Drawings
Design usually starts with schematic drawings. These are rough floor plan concepts that map out room layout, circulation, and the exterior direction. Think of this stage as getting the bones right before anyone sweats the fine details.
From there, the designer updates the plans based on your feedback until the layout works.
Once you approve the layout, the designer turns it into construction documents. These include:
- detailed floor plans
- elevations
- structural details
- a site plan
- energy code compliance information
These drawings need to be complete and accurate before they go in for review.
After that, the documents move into the local approval process.
Permits, Zoning, and Local Approvals in Michigan
In Michigan, permits often involve more than just the building permit. Depending on the lot and where the home sits, you may also need zoning approval, a driveway permit, a soil erosion control permit, and, for rural properties, well and septic permits. Each one can come from a different office, and each may move at its own pace.
That’s why local knowledge matters. Rules can change from one county or municipality to the next, so the builder needs to track every approval tied to the project.
| Approval Type | Issuing Authority | When It's Needed |
|---|---|---|
| Building Permit | City, township, or enforcing agency | Before any construction begins |
| Zoning Review | Local zoning board or planning department | Before permit submission |
| Driveway Permit | Road commission or county | Before site access is established |
| Soil Erosion Control | County drain commissioner or EGLE | Before grading or excavation |
| Well & Septic Permit | County health department | Before site work on rural lots |
A delay in any one of these can push back the groundbreaking date. Submitting the permit package early, with complete and accurate drawings, gives you a better shot at keeping the timeline in line. Once approvals are cleared, the builder can line up site work.
sbb-itb-f29a061
Site Work, Foundation, and Getting the Shell Dried In
Clearing, Grading, and Preparing the Site
Once approvals are done, the job moves off the page and onto the lot. This is the point where dirt starts moving and the build feels real.
Site prep usually covers clearing, grading, excavation, and setting up temporary access for soil stockpiles. Before crews dig, they may also check soil conditions, site grades, and flood risk. From there, the work shifts into excavation and footing layout.
Excavation, Footings, and Foundation Work
With the site prepped, excavation brings the foundation down to the right depth. Before any concrete is poured, footings are inspected.
Foundation work usually includes footing placement, rebar installation, formwork, and concrete pouring. After the concrete cures, the project is ready for framing.
Framing, Roofing, Windows, and Exterior Dry-In
After the foundation is set, framing begins. Then comes one of the big early milestones: roofing. It plays a major part in the dry-in stage because it protects the structure from weather before interior work starts.
A build is considered "dried in" when the framing is up, the roof is on, and exterior openings are sealed against rain and wind. Barndominiums follow that same shell-first path, though the inside layout can differ from a standard house. After dry-in, crews can move indoors and start the rough-in trades.
Mechanical Rough-Ins, Insulation, and Interior Finishes
HVAC, Plumbing, Electrical, and Rough-In Inspections
After dry-in, the focus shifts inside. Crews install the systems that make the home livable, then the walls get closed up and the interior starts to take shape. This stage is called mechanical rough-ins. It covers the main systems that go in before drywall.
HVAC crews run ductwork and set heating and cooling equipment. Plumbers install water supply and waste lines, and on Michigan properties, that can also include well or septic connections. Electricians pull wiring through the framing and set panel locations. These trades work one after another, and the builder manages the schedule so the job keeps moving.
There’s one hard rule here: these systems can’t be covered until they pass inspection. In Michigan, mechanical, plumbing, and electrical rough-ins must be approved before insulation or drywall can start.
Insulation, Drywall, and Interior Finish Work
Once inspections are signed off, insulation goes in first. Then comes drywall hanging, taping, and finishing.
After that, the home moves into interior finish work. This usually includes cabinetry and millwork, flooring, tile, and the last detail items that start making the space feel finished. Good scheduling matters a lot here. Deliveries have to land on time, and each trade has to hand off the space cleanly to the next one.
It helps to lock in cabinetry, millwork, lighting, and the electrical layout early. If those choices come late, deliveries can slip and inspections can get pushed back.
Finish Options for Custom Homes vs. Barndominiums
At this point, the build sequence stays about the same. What changes is the finish scope.
Custom homes often lean into more detailed interior finishes. Barndominium projects, by contrast, often focus on practical, open-plan interiors with a simpler finish package.
How to Build a Custom Home: From Finding a Builder to Closing
Final Inspections, Walkthrough, and Move-In Readiness
Once the interior work is done, the project shifts into closeout.
Final Approvals and Certificate of Occupancy
After the finishes are in place, the home goes through final inspections. In Michigan, local officials do one last review of the building, electrical, plumbing, and mechanical systems. Grading and zoning sign-offs are part of this stage too before anyone can move in. The Certificate of Occupancy (CO) is the final legal approval to occupy the home. It confirms that the house meets local code and safety rules.
The Final Walkthrough and Punch List
After final inspections, walk through the home with your builder before closing out the project. This is your chance to spot anything that still needs attention and put it on a punch list.
| Punch-List Category | Typical Items to Check |
|---|---|
| Cosmetic | Paint touch-ups, trim alignment, flooring scratches, cabinet finishes - may be resolved after move-in under warranty |
| Functional | Appliance operation, HVAC performance, window and door seals, drawer glides - confirm working before signing off |
| Safety & Code | GFCIs, smoke detectors, plumbing leaks, handrails, exterior drainage - must be resolved before move-in |
Pay close attention to the small stuff. A scuffed floor or crooked trim might seem minor, but this is the best time to document it. At the same time, test the things that matter day to day, like doors, windows, appliances, and HVAC. Safety items need even more care because they should be fixed before move-in.
It also helps to confirm that manufacturer warranties have been activated. Some products need a final manufacturer inspection before the warranty kicks in.
Key Takeaways for Homeowners Getting Ready to Build
After the walkthrough, closeout comes down to finishing the punch list and getting occupancy approval. Final-stage delays often happen because of design changes that trigger permit amendments, material lead times, or long agency review periods. Good communication with your builder and local officials helps keep approvals, closeout, and move-in on schedule.
FAQs
How much should I budget for unexpected costs?
Set aside a contingency fund for surprise costs. A common rule of thumb is 10% to 20% of your total project budget, based on how simple or complex the build is.
That extra cushion can help cover things like hidden site issues, last-minute design changes, or shifts in material prices. It’s a smart way to keep the project budget on track when the unexpected shows up.
When do I need to make my finish selections?
Finish selections should be made during the early planning and consulting stage. That gives your project a clear path from day one and helps keep it in line with both your budget and your design goals.
When you make these decisions early, allowances, alternates, and upgrade options are easier to define before construction starts. It also cuts down on rework and helps the team line up materials and trade schedules as each milestone comes into view.
What can delay my move-in date?
Move-in can slip when changes trigger new approvals or force rework. That tends to happen when permitting, inspections, or job site conditions don’t go to plan and the design has to change.
Scheduling can also slide when key decisions, materials, or major equipment aren’t ready at the right time. This often hits during foundation, framing, mechanical, or finish work. And once a change shows up after an earlier milestone, delays can stack up fast.
